Orders, options or current tenders for trams, light rail vehicles and metrotrains for companies in Germany – the current overview as of 1 March 2025:
We are once again presenting this compilation in the first quarter of 2025. It dates back to 1993 and is now the 25th list of its kind.
The headline for the corresponding report in Urban Transport Magazine in March 2024 was
“Little new and much later” – What’s the case for this year?
Actually, both apply, but with the welcome addition that considerably more new vehicles were delivered in 2024 than in the previous year. Deliveries were finalised in Freiburg and Cologne (last vehicle HF6).
In Darmstadt, Düsseldorf and Essen, only a few vehicles from larger deliveries remained to finalise deliveries.

The first vehicles from ordered deliveries arrived in Brandenburg, Cottbus, Essen (HF 1), Frankfurt (Oder), Halle an der Saale, Magdeburg, Rostock and Würzburg in 2024. Bielefeld received a single new tramcar, Frankfurt am Main two, and Woltersdorf the complete delivery of all four tramcars ordered from Polish production.
A number of manufacturers were again affected by delivery delays in the reporting period, with delays of varying lengths. Alstom is still at the top of the list with delays of over 30 months in some cases. Stadler plants in Spain and a supplier in Switzerland were affected by bad weather, which led to delays in the completion of vehicles.
Options converted into orders
- Berlin: Options for ‘Urbanliner’ increased by 30 to 45, 52 options remain, total number (97) thus unchanged
- Dresden: Option for 7 NGTX(10)DD redeemed. Delivery 2026-2027
- Duisburg: 13 new options for NF4. Total number now 67.
- Hanover: 17 further 4000 series light rail vehicles were ordered from CAF from an option in January 2025. One option of 16 vehicles remains.
- rnv: An option for 34 further units of the three-section type 36T For City Smart was honoured at the end of 2024.
- Stuttgart: The option for 30 additional DT 8.16 light rail vehicles has been honoured. 70 vehicles have now been ordered.
New orders
- Gotha: 4 100% low-floor trams, two-directional, Tramlink type (ordered 01-2025) plus 4 + 2 options
- Potsdam: order for 10 Tramlink split into 2+8
- Ulm: Order for two additional centre sections each for 18 Avenios (extension from 5 to 7 sections)

Open & expected tenders:
- Bonn: a construction train consisting of two tramcars and one transport tramcar was put out to tender
- Braunschweig: A tender was issued for twelve low-floor single-ended light rail vehicles plus ten options. The planned width was reduced from the original 2.65 metres to 2.30 metres. The project of an extended track spacing for the use of wider vehicles is therefore unlikely to be pursued further.
- Bremen: The tender for an EGW road-rail vehicle was cancelled
- Darmstadt: A road-rail vehicle for rail cleaning was put out to tender
- Freiburg: Preparation of a tender for 50 to 65 100% low-floor tramcars in bidirectional design to replace existing vehicles in the years 2029-2040
- Cologne: Soundings are reportedly continuing with two manufacturers for the planned new high-floor tramcars. A market enquiry has been launched for a new rail grinding train.
- Mainz: 22 low-floor tramcars with a 70% low-floor share in bi-directional design have been put out to tender. A planned further option for 8 units has been cancelled for financial reasons.
- Krefeld/Oberhausen/Ruhrbahn: The three metre-gauge companies in North Rhine-Westphalia are preparing a joint tender for a total of 53 bi-directional trains with a 70% low-floor share. Seven three-section units are to replace the last high-floor M light rail vehicles are planned for Krefeld, and 6 or 40 four-section units for Oberhausen and the Essen section of the Ruhrbahn.
- Rhein-Main (rnv): The procurement of up to 25 high-floor 2-system tram-train units as bi-directional units is planned for a railway line that is still in the preliminary planning stage and is to be converted to tram-train operation. An award procedure was initiated in spring 2024 and operations are scheduled to start at the end of 2028. As the vehicles must be designed for platform heights of 76 to 96 cm, participation in the current VDV project is ruled out.
Current orders and deliveries in detail:
Augsburg
So far, only four of the 15 Tramlink (Stadler) tramcars ordered have arrived. Two of them in August and December 2023, two more in August and September 2024. It is not yet possible to predict when they will be used for passenger transport. The problem here is the TAB Oberbayern – see also Munich.
Berlin
Of the 20 nine-car ‘Urbanliners’ ordered from Alstom, the first vehicle arrived in June 2024. The second vehicle was exhibited at InnoTrans in Berlin in September and then returned to the manufacturer. The further progress of deliveries and approval for scheduled services are unclear. The first acceptance and test runs took place on various routes at the beginning of 2025.

Bochum-Gelsenkirchen
The type B light rail vehicles procured from 1989 for the only standard-gauge light rail line U35 undergo a complete refurbishment at Stadler in Berlin. The first vehicle returned to its place of use at the beginning of March 2024. The carriages, known as the B80neo, have adapted control technology (TCMS), which allows them to be used in a mixed train formation with the Tango tramcars. The second vehicle followed in September, which also enabled driving tests to be carried out in a train formation. They have not yet received a licence.

Bonn
On 12 December 2024, the new Skoda T41 tramcars were put into passenger service – a maiden voyage for invited guests had previously taken place on 7 December. Six vehicles were in Bonn by the end of 2024. Four more followed in January and February 2025. They bear the numbers 2251 – 2253 and 2351 – 2357, with tramcars 2358 and 2359 to follow. The others will be numbered from 2451 onwards, possibly also as 2551. Only four units are currently authorised for passenger transport. At present, they can only be used on line 61; for the tunnel sections travelled by the SL 62, adaptations to changed fire protection regulations are necessary for approval.
In the meantime, a buyer has been found for the first series of low-floor cars from 1993-94 in the form of the transport company in Poznan, Poland (MPK Poznan). They will take over the 24 tramcars, at least two of which are already parked in Bonn, and the spare parts warehouse. The takeover should be completed within a year. We reported here:
https://www.urban-transport-magazine.com/poznan-kauft-die-bonner-niederflurbahnen/

Brandenburg, Cottbus, Frankfurt (Oder)
All three purchasers of the ‘Brandenburg Tram’ from Skoda received their first vehicles in 2024, up to one year late. The first of four ordered tramcars arrived in Brandenburg on 18 December. Cottbus had already received its ‘No. 1’ of an initial seven units on 6 June. Tramcar 2 also arrived in January 2025. Frankfurt an der Oder was the first company to receive a new vehicle from Skoda in April 2024. A further three of the 13 units ordered followed in July, September and October. At the end of the year, none of the vehicles had yet been approved for passenger transport. We reported here:
https://www.urban-transport-magazine.com/begruessung-erste-neue-skoda-strassenbahn-in-cottbus/
Darmstadt
Unfortunately, the commissioning of the 5-car TINA trams has not yet gone ‘smoothly’. Although all 14 units of the first series ordered were delivered in 2023, this was followed relatively soon by the first eleven units from an option that had been exercised. Five of these were available by the end of 2024. However, there are still problems in operation, which mean that at most half of the tramcars are in use. Residents living near the lines complain about the perceived excessive noise and vibrations of the carriages, which are equipped with special new running gear. The use of high-floor vehicles cannot be dispensed with for the time being.

In 2023, ten of the 30 four-axle low-floor sidecars procured in 1994 were brought to Talbot in Aachen for refurbishment to extend their service life. There it turned out that the refurbishment costs were higher than expected and uneconomical in view of the planned further service life. They therefore did not return to Darmstadt, but only two were scrapped in Aachen, as one sidecar was given to the Darmstadt fire brigade as a training vehicle and seven were taken over by the tramway in Gera, Thuringia. Six of these are to be refurbished for use behind the NGT8G eight-axle vehicles in the company’s own workshop to increase transport capacity, while one will be used as a spare parts donor. The tramcars are of the same type as the sidecars already running behind them in Darmstadt, so no problems are expected. In Darmstadt, 13 sidecars were still operational in October 2024.

Dortmund
At the end of 2023, eight of the 34 Vamos light rail vehicles ordered in the meantime had been delivered. 14 were added in 2024, leaving twelve vehicles still missing. After approval, 23 April 2024 was the first day of operation in regular service. The number of trains, initially only a few on two lines, was continuously increased until the end of the year.
In June 2024, the first modernised tramcar in the existing fleet (tramcar 348) also returned to Dortmund from Heiterblick.

Düsseldorf
After a break of several months, delivery of the HF 6 light rail vehicles continued from December 2023, so that 29 tramcars were ready for use by the end of the year. In 2024, 21 vehicles were added quite quickly by September, so that the manufacturer’s announced target of having all 59 units ready by the end of 2024 seemed realistic. However, it was not until December that three more vehicles were delivered, leaving seven units still missing at the end of the year.
The new deliveries made it possible to decommission the remaining units of the modernised high-floor eight-axle GT 8SU, for which there was a farewell run on 29 December. At this time, two double trains were still operational, most of the others had previously been decommissioned. The transport company in Krakow, Poland, also received wagons as spare parts donors for the previous generation GT8S in service there. The operating licence for the GT8SU on the Rhine ended on 31.12.2024. They were the last to use the old train control system in the tunnel, which was then also deactivated.
Duisburg
Delivery of the NF4 (Gt8ND) low-floor carriages continues to be slow and in some cases with longer breaks. Originally, 47 units were ordered for delivery from the end of 2020. The first few vehicles did not enter service until 2022, followed by a further 13 by the end of 2023. Instead of paying a fine as a penalty for the delay, the manufacturer increased the number of vehicles by two units at its own expense. They are to be delivered in 2026 following the delivery. Despite the problems, Duisburg had already ordered five more tramcars from an option in October 2022, which was supplemented with a free allocation of 13 units in March 2024, so that a total of 67 NF4s will be delivered. The manufacturer Alstom had planned to deliver a total of 32 tramcars by the end of 2024 and the rest in 2025, but only 24 were delivered, so it seems unrealistic to be able to deliver the missing 41 tramcars by the end of 2025 plus the two penalty units in 2026. The question is also how long the vehicles to be replaced will last, as they have long since reached the end of their service life and some of them have already been scrapped or parked. The new deliveries, which far exceed the current stock, are intended to improve the timetable, although one can only hope that the necessary personnel will be available.
Delivery delays of at least two years for the 109 Avenio high-floor tramcars from Siemens ordered jointly by Duisburg and Düsseldorf were already announced last year.
Essen/Mülheim (Ruhrbahn)
Of the 26 low-floor coaches in the first order, 23 had been delivered by the end of 2024. In January 2024, an option for six additional units was exercised, which are expected to be delivered in 2025.

Of the 51 standard-gauge high-floor tramcars ordered from CAF for the light rail network, the two advance tramcars (tramcars 5303, 5304) were delivered on time in July 2024. A further two were in the test phase at the Spanish manufacturer’s plant. The test runs carried out in the second half of the year also attracted the interest of Bonn’s municipal utilities, which ordered 32 almost identical vehicles, the first two of which should arrive there at the end of 2024.
Frankfurt am Main
‘Showdown’ on the Main: At the beginning of November 2024, Verkehrsgesellschaft Frankfurt (VGF) took all 14 tramcars of the three-part 100% low-floor Type T tramcar from Alstom delivered up to that point out of service. The reason for this was the continuous problems that had been occurring in use since the first carriages were delivered in 2022, which the manufacturer was unable to resolve. Initially, 16 of the short version had been ordered, but by honouring options and an additional construction instead of penalties, a further nine units were added, which are now not scheduled for delivery until 2026. The delivery of the first four-section, of which 36 units are to be delivered, has been announced repeatedly since 2023, but has not yet taken place.

The current situation poses major problems for the transport company. The first generation of R-type low-floor trams, which were originally intended to be taken out of service and sold to Budapest, must now be kept running. General inspections had previously been rejected as ‘no longer profitable’. Some of the Pt high-floor carriages, which are now over 50 years old and are absolutely reliable but no longer up to date, also had to be reactivated. There is also an increasing shortage of spare parts.
The situation with the Type T remains unchanged in mid-March 2025. The VGF called on the manufacturer to bring about a stable deployment of vehicles as quickly as possible or otherwise to withdraw them from service. Alstom is reportedly working intensively on site to rectify the existing technical problems. According to media reports, these are software problems, problems with opening and closing the doors and the boarding height.
Of the 23 centre carriages to be delivered for the U5 light rail vehicles, which were supposed to be delivered by 2022, five were still missing at the end of 2024.
Built by Windhoff, two new rail grinding carriages were put into service.
Gera
In December 2023, six 5-carriage 100% low-floor TINA cars were ordered from Stadler for delivery from 2026. The number of options was reduced to three by politicians.

To increase the available space, the company took over six four-axle low-floor trailers from Darmstadt, which are also to be used behind low-floor eight-axle coaches.
Gotha
Gotha 2024 is the only operation to have placed an immediate order following a tender published at short notice. Four two-light vehicles in 100% low-floor design were to be delivered in 2025-26. Two options for 4 and 2 further vehicles were also awarded. Although test runs with a Skoda three-carriage vehicle from Rhein-Neckar-Verkehrsgesellschaft took place in 2023, the company opted for the Tramlink type from Stadler in a 30-metre-long three-car version when the contract was awarded. Similar vehicles operate in neighbouring Erfurt.
Halle (Saale)
On 6 December, the first five-car TINA arrived in the city on the Saale. The second followed on 11 January 2025. 17 long units and 39 short, three-car vehicles have been ordered. This is the first time that wagons of this type in Halle have been two-directional. The long version is to be delivered first, followed by the short carriages from 2026.

Jena
Stadler delivered its first series of 16 seven-car Tramlinks 2023-24 to the Thuringian university city one year late. This was immediately followed by the first five-car units from an initial order of eight from July 2024. A further nine from an exercised option will follow by the end of 2025. The vehicles in an attractive livery are referred to here as ‘Lichtbahn’.
Cologne
The current situation in Cologne is probably best described as precarious. Not only does the lack of staff appear to be becoming a permanent problem and has now led to the third stage of service restrictions, but the situation in the vehicle sector is also tense.
In November 2020, the Cologne Transport Authority (KVB) had already placed a major order for new low-floor vehicles to replace the first generation of such vehicles (K 4000), which were delivered from 1994. Delivery was to begin with four preliminary trains in 2023, with series production to follow in 2024-25. For the past two years, the manufacturer Alstom has only announced delays in delivery due to internal problems, which have currently reached a level of 33 months.
This is forcing KVB to continue using the K4000s, some of which are now 30 years old and were originally designed for a maximum service life of 25 years, which is becoming increasingly difficult due to a lack of spare parts. Individual carriages have already been parked and are being used as spare parts donors. In the meantime, one vehicle has been to Talbot in Aachen to determine the cost of an overhaul. This is considerable. A tender is currently underway for this, which, once awarded, will take some of the wagons actually required for operation out of service for a longer period of time.

Problems are also beginning to emerge for the fleet of the high-floor light rail network with regard to the age of the vehicles currently in use and delays in the procurement of replacements. In 2022, KVB surprised the public with the presentation of a new deployment concept in which the train length was to be varied by adding or removing an individual vehicle module. However, it remained unclear how this could be achieved in practice. A corresponding invitation to tender in 2022 was therefore also unsuccessful. Negotiations with wagon builders have not yet yielded any results in line with the transport company’s expectations. In view of the current delivery times, it is therefore unlikely that new high-floor wagons will be available before the end of the decade.
Magdeburg
Magdeburg has ordered 35 four-car Flexity Classic single-unit coaches from Bombardier for 2021. Delivery began on time in September 2024, initially with two vehicles for testing. Series delivery is then planned from mid-2025. If one vehicle is delivered each month, the order will be fully processed in the second half of 2027. There is an option for 28 more vehicles.

Mainz
No contract has yet been awarded in response to the tender launched in 2023. However, it has been announced that the Polish manufacturer PESA has submitted a bid. We reported on the new Twist 3.0 platform from PESA here:
Munich
Siemens is delivering one per month of the total of 73 Avenio four-section trams ordered to Munich. Deliveries began in 2021 and 39 had been delivered by the end of October 2024. The approval of the vehicles by the technical authorities (TAB) is proceeding slowly, as is unfortunately the usual way in Bavaria. At the same time, 18 vehicles await the approval process stored at the depot.

In the summer, the supervisory authority approved the use of two two-section Avenios in the double-traction coupled formation. Since August 2022, double traction operation of two- and three-section units has been authorised.
Nuremberg
Of the 26 four-sectionAvenios ordered, only a few units were still missing at the turn of the year. The eight Stadler Variobahn trams delivered in 2007-08, on the other hand, have been causing frequent problems right from the start, so that the company is looking for a buyer. Three of them have already been cancelled.
Potsdam
Delivery of the nine seven-car Tramlinks ordered from Stadler in November 2021 is slightly delayed. The first vehicle was originally due to arrive in December 2024, but this could not be realised due to storm damage at the Spanish plant in Valencia. Delivery of the first vehicle started mid-March and will take until 2026. The vehicles manufactured at the Valencia plant in Spain will replace the last modernised KT4Ds in Potsdam. More info here:
https://www.urban-transport-magazine.com/erste-tramlink-strassenbahn-in-potsdam-vorgestellt/
Rhein-Neckar-Verkehr (RNV)
Von den drei Varianten der Skoda-Niederflurwagen für den Rhein-Neckar-Verkehr sind bis Ende 2024 folgende Stückzahlen geliefert worden:
- 3-teilig, Type 36T: 8 Stück in 2023, drei Stück in 2024. Bestellt 31 Stück
- 4-teilig, Type 37T: 19 Stück in 2024 *. Bestellt 37 Stück
- 6-teilig, Type 38T: 1 Stück in 2024 *. Bestellt 12 Stück.
* Diese setzten sich aus je zwei zwei- und dreiteiligen, trennbaren Zughälften zusammen, die jede für sich eine eigene Nummer tragen.
Eine Option auf 34 Dreiteiler der Type 36T wurde Ende 2024 zur Lieferung in 2026 eingelöst.
Rostock
Im Februar 2025 wurde der erste der bestellten 28 Triebwagen vom Typ TINA von Stadler geliefert. Es handelt sich um dreiteilige Einrichtungswagen.

Saarbrücken
The first VDV tram-train built by Stadler for Saarbrücken was exhibited at InnoTrans in Berlin in September 2024. Saarbahn is the first company to receive four tramcars as dual-system DC/AC vehicles. For this major order, six companies in Germany (4) and Austria (2) have joined forces and ordered a total of 246 vehicles in various configurations. A total of five variants are planned, with Saarbahn receiving the standard version.

Schwerin
The 30 three-part low-floor coaches procured between 2001 and 2003 will be gradually modernised from 2022. They will receive new exterior and interior lighting and changes to the passenger compartment as well as a new paint job.
Stuttgart
After Stadler Rail completed the delivery of 20 DT8.15 light rail vehicles in 2023, Stuttgart’s trams honoured an option for 30 more vehicles from the same manufacturer in February 2024. An initial series of 40 had already been ordered in 2022. However, the DT8.16s will have a different appearance to their predecessors. The high-floor two-car units to be delivered from 2026 have been redesigned, particularly at the front. The interior will have more space for rollators, wheelchairs and pushchairs, the boarding options will be improved and there will be Wi-Fi and USB ports.

Woltersdorf
The small company on the outskirts of Berlin took an unusual approach to achieving accessibility and initially ordered three four-axle, 100% low-floor bidirectional tramcars from the Polish manufacturer Modertrans in Poznan, which were later followed by a fourth model. Most manufacturers do not have such vehicles in their programme. Delivery began in May, with three coaches arriving at the end of 2024 and the last one following in January 2025. The somewhat unusual-looking vehicles had not yet been approved by the end of 2024. This came at the end of January for the first three vehicles. Since then, they have been in regular service.

On 1 March 2025, the two-axle vehicles were taken out of regular service. Due to a lack of space, the company is looking for buyers for some of its previously used Gotha T 57 two-axle vehicles, some of which will remain in Woltersdorf for historical transport services. Vehicles of this type are now only used for regular services on the Kirnitzschtalbahn in Bad Schandau and in Naumburg. We reported on the decommissioning here:
https://www.urban-transport-magazine.com/en/big-gotha-tram-farewell-in-woltersdorf/

Würzburg
On 18 December 2024, the first of 18 five-part 100% low-floor GT-F coaches built by HeiterBlick in Leipzig reached its future area of operation. The series plus 9 options had been ordered five years earlier in December 2019, but 60 months passed before delivery began due to capacity problems at the manufacturer. In addition, there was an unusually long lead time of two years before the contract was awarded. A further year is expected for the approval phase and the delivery of a sufficient number of vehicles for regular service.

The new vehicles are urgently needed, as the 20 GT-N low-floor vehicles of the second series delivered in 1996 have been experiencing technical problems since December 2023. Following the breakage of a swing arm on a chassis, series damage was suspected and the entire fleet was shut down for investigation. By late autumn, eleven of the 20 carriages were back in passenger service after thorough investigations. The timetable had to be drastically reduced at the beginning of 2024, and one route was temporarily converted to bus operation. The ‘saviours in distress’ for the second valley route were the six DÜWAG articulated coaches, which were still up to 55 years old, some of which had previously been used for school transport but were now back in service all day every weekday. They could not be used on the ‘mountain route’ to Heuchelhof, but the 14 three-part 1st series low-floor cars from 1988-89 with only a small proportion of low-floor cars were available for this purpose. We reported here:
https://www.urban-transport-magazine.com/3-auf-einen-streich-brandenburg-halle-saale-und-wuerzburg-erhalten-neue-strassenbahnen/
The metros
In Berlin, delivery of the new vehicles ordered for both the large profile and the small profile continues to be very slow. For the large profile (type J), one four-car train was delivered for testing purposes at the end of 2024, while two four-car trains and one two-car train were delivered for the small profile (type JK). According to the current delivery schedule, a further 18 JK trains are to be delivered as test and training vehicles between spring and summer 2025.

Delivery of the JK series is scheduled to begin in September and at the same time the test vehicles will be put into passenger service for the first time. Delivery of the J series test and training vehicles will begin at a later date, with series delivery starting in summer 2026. 236 wagons for the large profile and 140 wagons for the small profile have been ordered in total. In December 2024, a further 108 Type J cars were called up from the framework agreement for an initial 270 additional wagons, meaning that up to 1,500 units could be built in total.

Alstom won the tender for the new DT6 vehicles for Hamburg in July 2024. The 40-metre-long 4-car trains will be built at the Salzgitter plant. The first order for delivery from the beginning of 2028 comprises 48 units, seven of which are for driverless operation (DT6-A) and 41 for operation with staff (DT6-F). There are also a large number of options (113 DT6-A and 213 DT6-F). In contrast to the predecessor vehicles, the DT6s used are based on Jakobs bogies.

There are currently no more deliveries and options pending for the operations in Munich and Nuremberg and no new tenders are planned for the time being.

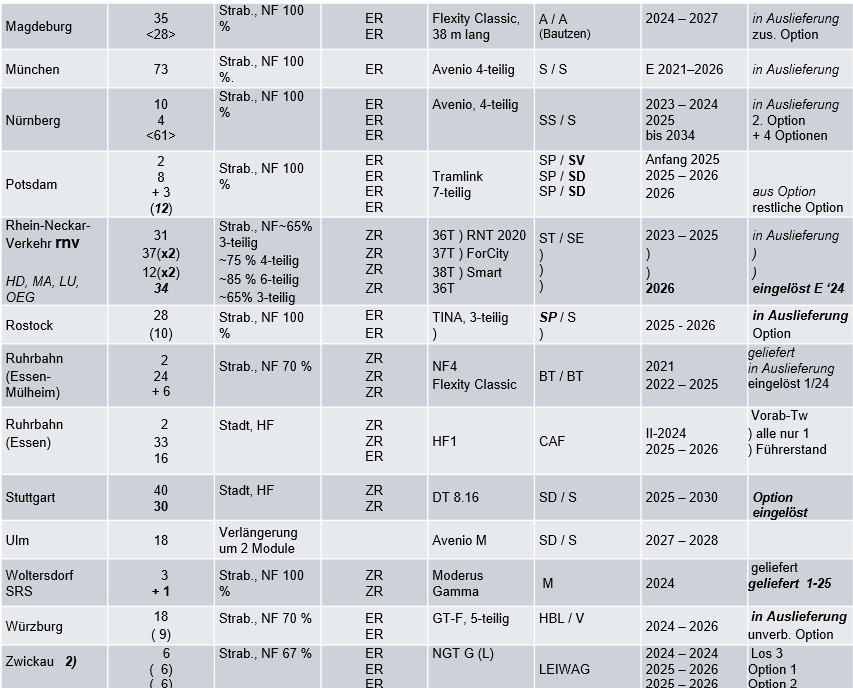

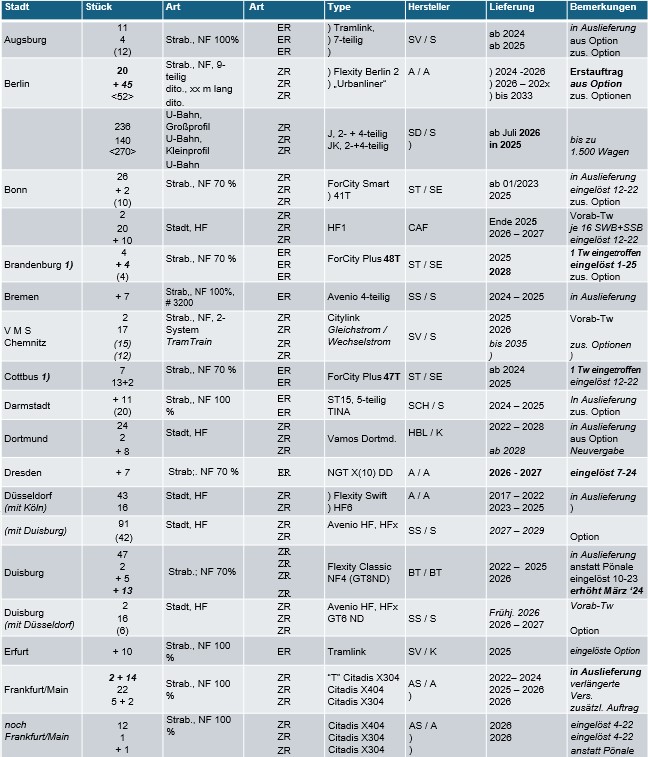

Table I: Vehicles in production or on order:



Table II: Open and planned tenders:

Comments to tables I and II:
1) joint order of Brandenburg, Cottbus and Frankfurt/Oder
2) joint order of Leipzig, Görlitz und Zwickau (different width of the vehicles: Leipzig 2.40 m, Görlitz und Zwickau 2.30 m; length: XXL: 45.0 m, L: 30.0 m)
3) planned joint tender of Ruhrbahn (Essen), Oberhausen and Krefeld
Number:
xx Number of vehicles on firm order
<xx> Number of vehicles expected to be ordered
(xx) Number of vehicles agreed as options
Type of vehicles:
ER single-ended
ZR bi-directional
Manufacturer:
(mechanical parts / electric equipment)
A Alstom (ex Bombardier BT)
AT Alstom Transport
AS Alstom Spain (Barcelona)
ABB ABB Elektrik
C Cegelec
CAF CAF Spanien
HBL HeiterBlick Leipzig
K Kiepe Electric
LEIWAG Corsortium HeiterBlick and Kiepe
M Modertrans Poznan
SCH Stadler Bussnang (CH)
SP Stadler Polen (ex Solaris)
SD Stadler Pankow
SV Stadler Rail Valencia
S? Stadler, no info re. The electric equipment
ST Škoda Transportation
STF Škoda Transtech, Finland
SE Škoda Electric
S Siemens Mobility
SW Siemens Vienna
SS Siemens Serbia (Sobovica)
V Voith Digital Solutions Austria
Table III: VDV TramTrains (on order since January 2022):

Comments to table III:
RSBNA = Zweckverband Regional-Stadtbahn Neckar-Alb
ENAG = Erms-Neckar-Bahn zwischen Reutlingen und Tübingen
SFBW = Landesanstalt Schienenfahrzeuge Baden-Württemberg beschafft alle Bahnen für AVG und ENAG
Number:
xx Number of vehicles on firm order
(xx) Number of vehicles agreed as options
Art:
ER single-ended
ZR bi-directional
TT TramTrain for railway lines (15 kV, 16 2/3 Hz)
NF low-floor (40 cm entry)
MF middle-floor (60 cm entry)
Manufacturer: Stadler Rail
